AS 3788:2024 — In-Service Inspection of Pressure Equipment

Stay compliant in Queensland with this practical guide to AS 3788:2024. Learn how to plan inspections, set risk-based intervals, choose the right NDT, prepare for audits, and manage PSVs and piping.

AS 3788:2024 — The Complete Queensland Guide to In-Service Inspection of Pressure Equipment

When pressure equipment fails, it’s rarely small. AS 3788:2024 exists to keep boilers, air receivers, pressure vessels, heat exchangers and piping safe, reliable, and legally defensible throughout their entire life. This guide translates the standard into plain English with a Queensland focus—what’s in scope, how to build a compliant inspection plan, how to set intervals the right way, which NDT to pick, and how to present records that satisfy WorkSafe Queensland.

Whether you run a single workshop compressor or a complex plant with multiple boilers and exchangers, you’ll get a practical blueprint you can implement this week.

What AS 3788 covers

AS 3788 sets the minimum requirements for in-service inspection of pressure equipment after it’s installed and commissioned. In practice, it tells you:

  • What to inspect (external/operational checks, close-ups, internals, NDT, and where justified, pressure tests).

  • How often to inspect (time-based or risk-based intervals).

  • How to decide fitness-for-service (continue, restrict, repair/replace, or re-rate).

  • How to manage changes (repairs, modifications, alterations, re-rating).

  • What to record (plans, procedures, results, recommendations, actions, and evidence of closure).

AS 3788 aligns with—and is often used alongside—other Australian standards for maintenance, valve testing and specific equipment types. Treat it as the framework that guides your decisions and the evidence file you’ll show an auditor.

Who this guide is for

  • Owners and operators of boilers, air receivers, vessels, exchangers and piping.

  • Maintenance and reliability teams responsible for inspection planning and execution.

  • NDT providers and inspection bodies who need to align scopes and reports with AS 3788.

  • Project and shutdown planners who must schedule openings, NII and PSV work without unnecessary downtime.

How Queensland compliance fits in

Queensland requires plant registration for certain pressure equipment, typically aligned to hazard levels (AS 4343). Registration, inspection plans, PSV certificates and UT trending are common audit focal points. If you don’t know the hazard level, have a competent person determine it from design and operating data.

Audit tip: Regulators assume “not documented = not done.” Keep a clean paper trail: plan → work pack → report → actions → close-out evidence.

Confined space entry preparation for internal vessel inspection under AS 3788

Time-based vs risk-based inspection

Time-based inspection (TBI) uses standard intervals (e.g., annual external, periodic internals) that suit many sites with straightforward duty. It’s predictable and easy to schedule.

Risk-based inspection (RBI) tailors scope and interval based on the real risk (probability × consequence) for each item. Good RBI focuses attention (and budget) on high-risk equipment while avoiding unnecessary opening of low-risk items.

How to pick:

  • Choose TBI for simple services, limited history, or when you’re building a program from scratch.

  • Choose RBI where you have varied services, strong condition data, or costly openings; RBI usually pays for itself in fewer unplanned outages and more targeted work.

Setting and adjusting inspection intervals

Intervals are engineering decisions, not calendar habits. Build them from:

  1. Service understanding — pressure, temperature, fluid, contaminants, start/stop cycles, upsets.

  2. Credible damage mechanisms — identify what could actually happen in your service (e.g., CUI, SCC, erosion-corrosion, fatigue).

  3. Technique suitability — pick methods that will detect that specific damage where it’s most likely to occur.

  4. Evidence — UT trends, corrosion rates, leak/failure history, chemistry and water management, coating/insulation condition, PSV test records.

Adjusting intervals:

  • If data shows stable, predictable degradation and strong protections, you may extend (with documented rationale).

  • If you see accelerating corrosion, new pitting, cracking or barriers not performing, shorten until risk is under control.

  • Deferrals to align with shutdowns can be acceptable if you demonstrate stable conditions and add temporary checks (e.g., opportunistic UT). Keep them short, justified and logged.

Non-intrusive inspection (NII) the right way

NII can replace internal entry only when you can prove the selected techniques will find the expected damage with adequate coverage and sensitivity. Typical patterns:

  • Pressure vessels with CUI risk: remove inspection bands at low points, supports and water traps; use VT + UT/PAUT; consider profile RT in localised areas.

  • Exchangers: UT grids on shells and nozzles; eddy current/RFT for tube inspection; PAUT at tube-tubesheet and nozzle blend radii.

  • Sour service (HIC/SOHIC risk): shear-wave UT/PAUT, hardness/replication where appropriate.

Key point: NII by itself doesn’t justify extended intervals. It’s a technique choice, not a free pass. Show your coverage and PoD (probability of detection) logic.

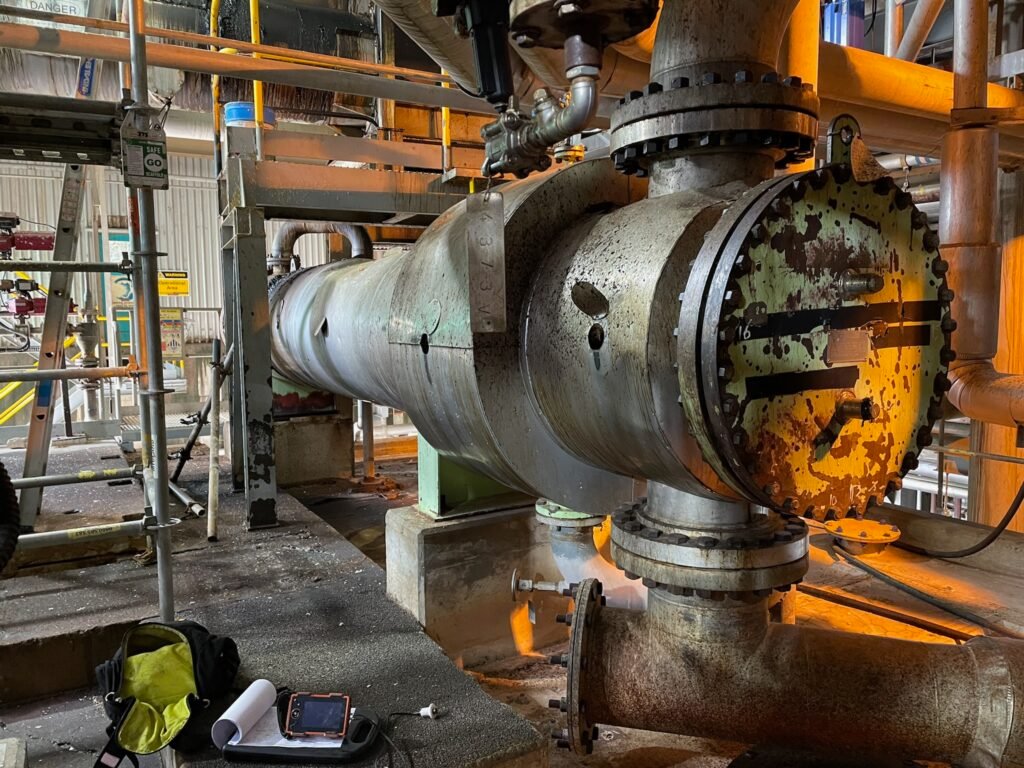

Insulation band removed to check for CUI at vessel support and lower shell.

“Boilers, receivers, piping—each ages differently. AS 3788 gives you a plan that keeps up: risk-based intervals, targeted NDT, audit-ready records.”

Damage mechanisms → where to look → what to use

Damage mechanismLikely hotspotsEffective methods
General corrosionShells, heads, low points, dead legsUT spot/grid; corrosion rate trending
Pitting / under-depositExchanger shells & tube sheets, low-velocity areasUT grid, pit gauges; eddy current/RFT for tubes
CUI (corrosion under insulation)Insulation terminations, supports, low points, penetrationsStrip bands + VT, UT/PAUT; profile RT where justified
Erosion-corrosionElbows, reducers, tees, control valve outletsUT trending; PAUT at thinning regions
SCC (chloride/caustic etc.)Weld toes, HAZ; hot/wet areasPT/MT for surface; PAUT/TOFD for subsurface
HIC/SOHIC (sour)Mid-wall in susceptible steelsShear-wave UT/PAUT; hardness/replication
Fatigue / thermal cyclingNozzles, attachments, supportsVT with magnification; PAUT at fillet/attachment welds
Creep (high temp)Long-service shells, headersReplication, hardness, deformation surveys

PSV pop test bench showing set pressure and seat tightness results for certification.

PSV/relief device management that stands up in audits

Your relief system is the last line of defence. Keep it boring (and compliant):

  • Traceability: Each PSV/PRV tag must map to the protected equipment, set pressure and service.

  • Certification: Maintain current pop/bench-test evidence; log set pressure, lift and seat tightness (as-found vs as-left).

  • Valve status: Ensure no blocked relief paths. Any isolation must follow a strict, documented protocol.

  • Change control: Re-assess whenever process conditions or relieving scenarios change.

Piping circuits: smart coverage without blowing the budget

Piping is often the largest risk surface and the hardest to manage. Streamline with:

  • Circuits by corrosion environment (not only by line number).

  • CMLs/TMLs at elbows, reducers, low points and known water traps; include small-bore connections and dead legs.

  • Screening first (guided wave or screening UT on long runs), then target with A-scan UT.

  • Update isos when repairs and replacements occur; stale drawings = missed hotspots.

Building an audit-ready inspection plan (step-by-step)

1) Equipment register

  • Unique ID, description, location, fluid, design code, MAWP/temperature, corrosion allowance, hazard level (AS 4343), registration status.

2) Strategy and rationale

  • TBI or RBI and why; expected damage mechanisms by component; operating envelope and excursions that matter.

3) Scope by inspection type

  • External/operational: leaks, noise/vibration, hotspots, supports/clips, drains/low points, insulation/coating, nameplates/markings.

  • Close-up: detailed VT for nozzles, attachments, saddles, small bore branches.

  • Internal (if opened): shells/heads, internals (trays, baffles, demisters), nozzles, weld seams, deposits/erosion.

  • NDT & tests: method, coverage (grids, CMLs), acceptance criteria, and reporting format.

  • PSVs/PRVs: interval, set pressure, leakage acceptance, tagging and cert retention.

4) Access and preparation

  • Isolation/spading, cleaning/neutralisation, gas tests, scaffolding/rope access, lifting points, confined space permits, insulation removal bands.

5) Evaluation & acceptance

  • Minimum wall calculations and remaining life formula, crack acceptance by method, deformation limits, FFS decision tree.

6) Reporting & records

  • Standardised report with photos, UT tables, as-found/as-left condition; recommendations with priorities and due dates; revision control and storage path.

Inspector performing ultrasonic thickness survey on an air receiver in Queensland to AS 3788.

Common Issues, Risks & What to Watch Out For

Hidden fatigue cracks in welds or high-stress zones

Bolt loosening or fatigue failure (especially in tension joints)

Severely corroded or pitted structural steel

Excessive wear internal to gearboxes or bearings (hard to detect without opening)

Wire rope core damage or broken strands not visible externally

Misalignment, binding, bearing play

Failed or inaccurate load-limiting devices or indicators

Electrical insulation degradation or connections loosening

Hydraulic leaks, seal failures under stress

Poor previous repair work or patches

Inadequate rectification of earlier defects

Underestimating downtime and logistical complexity

What equipment is covered by AS 3788?

Boilers, air receivers, pressure vessels, heat exchangers, piping systems and their relief devices once they’re in service.

Do I need hazard levels for everything?

Hazard level (AS 4343) informs registration and helps set inspection depth/frequency. For QLD compliance, it’s a key input.

Is risk-based inspection allowed in Queensland?

Yes—if it’s documented, uses competent people and yields intervals/scopes proportionate to risk.

When should the first in-service inspection happen?

Plan an early in-service confirmation (often around the first year) to validate assumptions and set a justified ongoing interval.

Can I defer an inspection to align with a shutdown?

Sometimes. Record stable conditions, risk controls and any interim checks. Keep deferrals short and traceable.

Can non-intrusive inspection replace internal entry?

Yes, when you can prove adequate coverage and sensitivity for the specific damage expected. It’s not a blanket substitute.

How many UT points do I need?

Enough to trend where damage is most likely (drains, low points, elbows, control valve outlets). Start with grids; refine with data.

Do I need to pressure test after every repair?

No. It depends on the repair type, code/design basis and your plan. Targeted NDT may be more appropriate

How do I manage exchangers without opening every time?

Trend shell UT and tube NDT (eddy current/RFT). Open when risk/cleaning requires it or data shows deterioration.

Our plant has many small air receivers—do they all need the same plan?

Create a template per type; customise only for unusual service or history.

Can I rely only on thickness readings?

No. Cracking, erosion and localised attack may need PAUT/TOFD, MT/PT or radiography.

What evidence should a PSV report include?

Tag, protected equipment, set pressure, as-found/as-left data, seat leakage result, tester, date, and next due date.
